Multiplexes are small projects with large-project execution complexity. Most of the airtime goes to policy. Less of it goes to coordinating BC Hydro, FortisBC, Rogers/Telus, and City storm/sanitary on a constrained urban lot — and to the site logistics of two or three structures on one site. A Theorem Developments builder's view.

Key takeaway

Multiplexes are relatively small projects but often come with large-project complexity from an execution standpoint. Most of the public conversation focuses on policy, zoning, and housing supply — much less on the realities of delivering these projects on the ground. A typical Vancouver multiplex requires coordination across BC Hydro for electrical servicing, FortisBC for gas, a telecom provider (Rogers or Telus), and the City for storm and sanitary servicing. Compared to a traditional single-family home or duplex, multiplex projects often require significant upgrades to site infrastructure and electrical capacity, which introduces another layer of coordination and planning. The biggest lesson Theorem Developments has learned is that being proactive in the design phase is critical. Onboard experienced electrical and civil consultants as early as possible — particularly teams that have direct experience working on residential multiplex projects in Vancouver. With BC Hydro specifically, early engagement is extremely important to understand servicing requirements, timelines, and whether off-site upgrades may be required. Builders are in many cases unable to self-perform or privately contract portions of off-site BC Hydro work, meaning projects become dependent on utility-provider scheduling and execution timelines. If those conversations happen too late, it can materially impact project completion schedules. On constrained sites, coordination between all utilities becomes increasingly important. Civil design needs to carefully consider the layout and routing of electrical, gas, telecom, storm, and sanitary lines to avoid conflicts both underground and at service-connection points. Telecom requirements are evolving on multiplex projects: providers that previously allowed aerial servicing on single-family homes are now requesting underground telecom infrastructure in certain situations — important to identify early, especially before hardscaping and landscaping are completed, because late-stage utility revisions can become costly and disruptive. Site logistics is another underestimated challenge. Many multiplex projects involve two or even three structures on constrained urban lots, where managing staging areas, material deliveries, truck access, lane conditions, overhead power lines, and construction sequencing becomes incredibly important. In many cases Theorem intentionally staggers the progress of buildings on-site, because trying to construct multiple buildings at the exact same pace can create logistical bottlenecks. Maintaining space for lumber, gravel, waste management, and trade access all becomes part of the construction strategy. Authored by Suraj Jhuty, P.Eng., Co-Principal of Theorem Developments, winner of two 2025 Georgie Awards from the Canadian Home Builders' Association of BC: Best Multiplex Home Projects and Best New Small-Scale Home up to 1000 SQ FT.

Multiplex small project large project execution complexityFive utility authorities BC Hydro FortisBC Rogers Telus City storm sanitaryMultiplex significant upgrades site infrastructure electrical capacity vs single family duplexBuilders unable to self perform off site BC Hydro work utility scheduling dependencyEarly BC Hydro engagement design phase servicing requirements timelines off site upgradesTelecom underground requirement evolving from aerial single family on multiplex projectsCivil design layout and routing electrical gas telecom storm sanitary avoid conflictsCoordination between all utilities on constrained sites underground and at service connection pointsSite logistics staging areas material deliveries truck access lane conditions overhead power linesIntentionally stagger building progress to avoid logistical bottlenecks on multiple structure sitesMaintaining space for lumber gravel waste management and trade access on constrained urban lotsElectrical and civil consultants onboarded at schematic design phaseLate stage utility revision cost after hardscape and landscape installedTheorem Developments 2025 Georgie Award Best Multiplex Home ProjectsSuraj Jhuty P.Eng. Co Principal Theorem Developments Vancouver multiplex builder
multiplex execution bc-hydro fortisbc telecom civil-design

Multiplexes are relatively small projects, but they often come with large-project complexity from an execution standpoint. Most of the conversation right now is about policy, zoning, and housing supply. There’s a lot less conversation around the realities of actually delivering these projects on the ground — which is what my team at Theorem Developments deals with after the rezoning is done.

TL;DR

  • A typical Vancouver multiplex requires coordination across BC Hydro, FortisBC, telecom providers (Rogers or Telus), and the City for storm and sanitary servicing.
  • Multiplexes often require significant upgrades to site infrastructure and electrical capacity compared to a single-family home or duplex.
  • The biggest lesson: be proactive in the design phase. Onboard experienced electrical and civil consultants early — and engage BC Hydro early too, because builders generally cannot self-perform off-site Hydro work.
  • Telecom is evolving. Providers that previously allowed aerial servicing on single-family homes are now requesting underground telecom in certain situations.
  • Site logistics is its own discipline. Many multiplex projects involve two or three structures on constrained urban lots, and managing staging, deliveries, lane access, overhead power lines, and construction sequencing keeps projects efficient.

Newly completed three-storey Vancouver multiplex photographed at blue hour on a narrow residential lot, white brick facade with dark window trim, peaked roof with warm illuminated cedar soffit, arched entry with a glowing wood front door, modern horizontal slatted black metal front gate with illuminated address number, low concrete retaining wall with Japanese maples and step-lighting, a BC Hydro service meter visible at the side gangway, neighbouring contemporary duplexes of mixed styles on either side

Utility coordination is the layer most teams underestimate

A major example of where small-project framing breaks down is utility coordination. On a typical Vancouver multiplex project, we’re coordinating across BC Hydro for electrical servicing, FortisBC for gas, telecom providers such as Rogers or Telus, alongside city storm and sanitary servicing requirements.

Compared to a traditional single-family home or duplex, multiplex projects often require significant upgrades to site infrastructure and electrical capacity. That introduces another layer of coordination and planning that owners and first-time multiplex teams routinely underestimate.

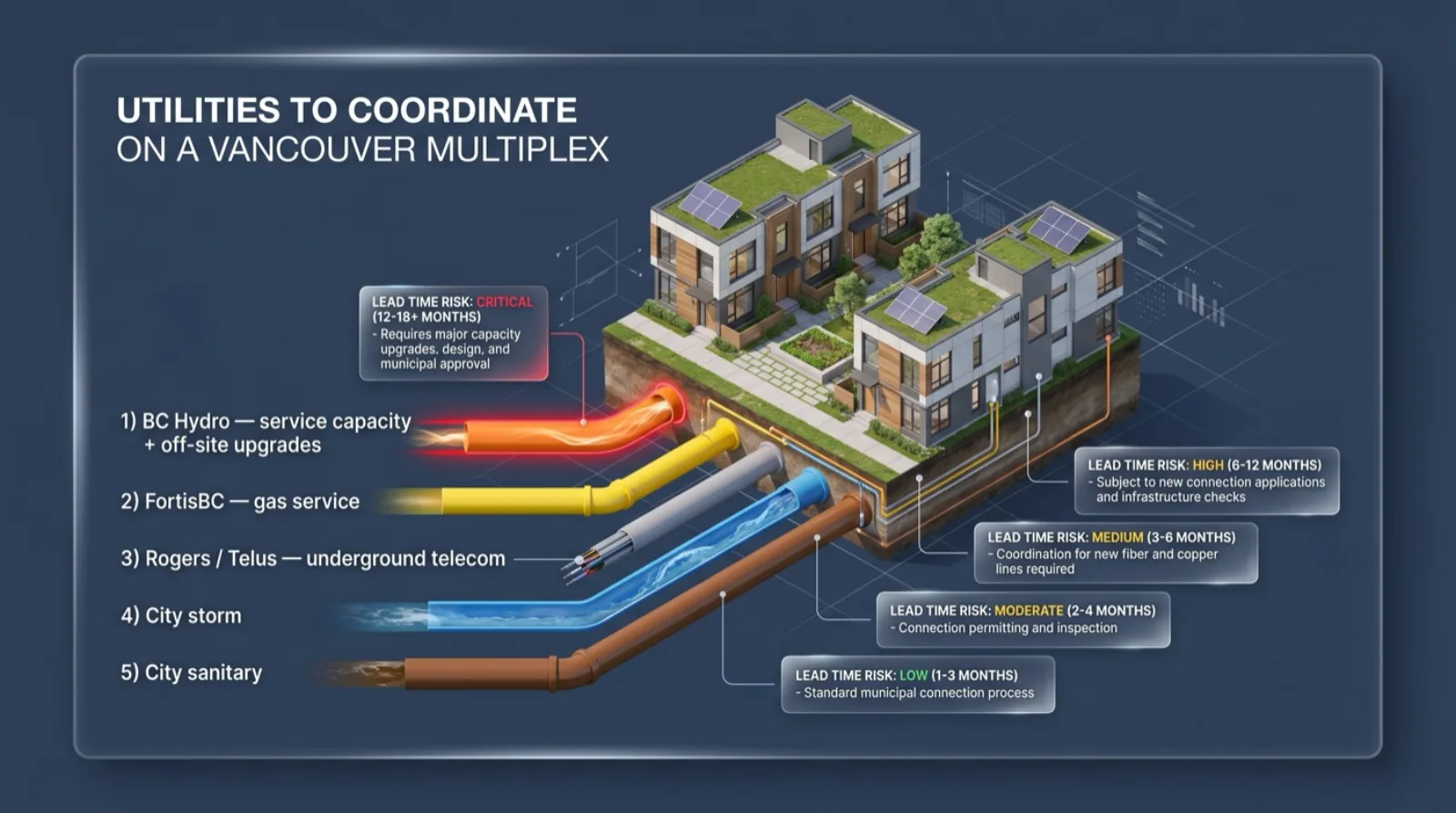

Professional 3D isometric infographic titled Utilities to coordinate on a Vancouver multiplex showing five colour-coded utility layers entering the lot BC Hydro electrical FortisBC gas Rogers Telus telecom city storm and city sanitary with lead time risk cards next to each layer showing BC Hydro as the long pole item

Being proactive in design is the single biggest lesson

One of the biggest lessons we’ve learned is that being proactive early in the design phase is critical. We strongly recommend onboarding experienced electrical and civil consultants as early as possible — particularly teams that have direct experience working on residential multiplex projects in Vancouver.

With BC Hydro specifically, early engagement is extremely important to better understand servicing requirements, timelines, and whether off-site upgrades may be required. In many cases, builders are unable to self-perform or privately contract portions of off-site BC Hydro work, meaning projects become dependent on utility provider scheduling and execution timelines.

If those conversations happen too late, it can materially impact project completion schedules. That part is hard to overstate. The building is small. The dependency on someone else’s crew calendar is not.

Coordination between all utilities — especially on constrained sites

Coordination between all utilities also becomes increasingly important on constrained sites. Civil design needs to carefully consider the layout and routing of electrical, gas, telecom, storm, and sanitary lines to avoid conflicts both underground and at service connection points.

We’ve also seen evolving telecom requirements on multiplex projects. Providers that previously allowed aerial servicing on single-family homes are now requesting underground telecom infrastructure in certain situations. These are important considerations to identify early — especially before hardscaping and landscaping are completed — because late-stage utility revisions can become costly and disruptive.

Site logistics — the part that’s invisible from the street

Another challenge that’s often underestimated is site logistics. Unlike a single-family home, many multiplex projects involve two or even three structures on constrained urban lots.

Managing staging areas, material deliveries, truck access, lane conditions, overhead power lines, and construction sequencing becomes incredibly important. In many cases, we intentionally stagger the progress of buildings on-site, because trying to construct multiple buildings at the exact same pace can create logistical bottlenecks. Maintaining space for lumber, gravel, waste management, and trade access all becomes part of the construction strategy.

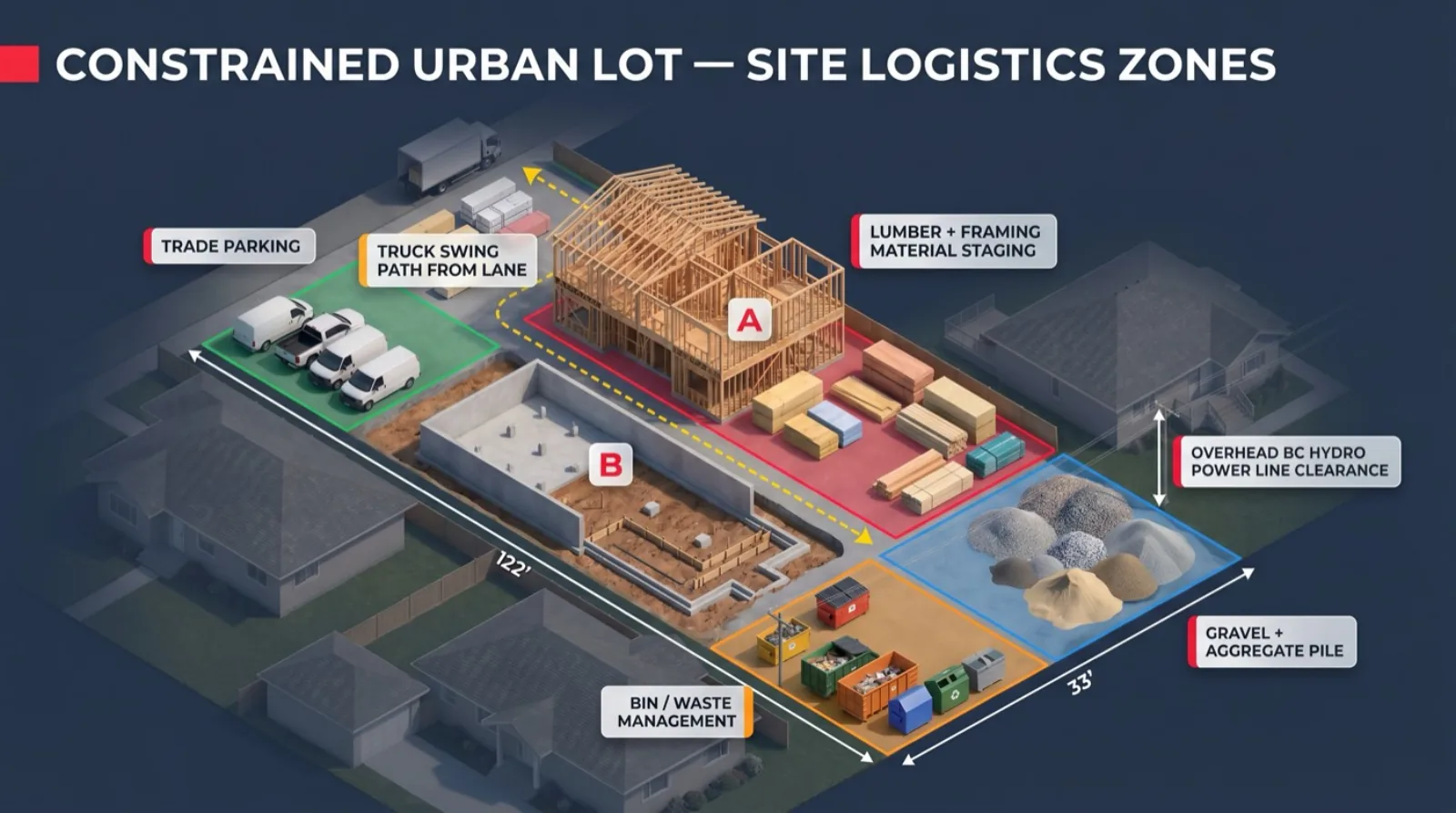

Professional 3D isometric site logistics diagram of a constrained urban Vancouver multiplex lot with two staggered multiplex buildings Building A in framing and Building B in foundation with colour coded zones for lumber and framing material staging gravel aggregate pile waste management trade parking and a truck swing path from the back lane with overhead BC Hydro power line clearance annotation

These are details that aren’t always visible from the outside, but they play a major role in keeping projects efficient and on schedule.

Frequently asked

Why are multiplexes treated as complex compared to single-family or duplex builds? The footprint is small, but the project requires upgrades to site infrastructure and electrical capacity that single-family and duplex builds usually don’t. That brings in more utility authorities, more coordination, and more dependencies on someone else’s schedule.

Which utilities does a Vancouver multiplex have to coordinate with? On a typical project: BC Hydro for electrical servicing, FortisBC for gas, a telecom provider (Rogers or Telus), and the City for storm and sanitary.

Why does BC Hydro need to be engaged early? To understand servicing requirements, timelines, and whether off-site upgrades may be required. Builders generally can’t self-perform or privately contract portions of off-site BC Hydro work, so the project ends up dependent on the utility’s scheduling. Late conversations materially impact completion.

What’s changing with telecom? On some multiplex projects, providers that previously allowed aerial servicing on single-family homes are now requesting underground telecom infrastructure. Identifying that before hardscaping and landscaping go in avoids costly late-stage revisions.

Why stagger building progress rather than building everything at once? On constrained sites with two or three structures, trying to construct multiple buildings at the exact same pace creates logistical bottlenecks. Staggering keeps staging space, deliveries, and trade access workable.


The buildings are small. The execution isn’t. The teams that ship multiplexes on schedule in Vancouver are the ones that treat utility coordination and site logistics as first-class design problems — not as a checklist someone fills out after permit.

Run your Vancouver lot through PlexRank to see whether it’s a multiplex candidate before you spend a dollar on design. If the lot scores, the next call is to a team that has actually wired one of these up before.

— Suraj Jhuty, P.Eng. | Co-Principal, Theorem Developments
